MEP BIM Coordination

The sprinkler routing changed. The mechanical services had already been coordinated.

40 Leadenhall case study: sprinkler route changed, mechanical services re-coordinated, with before and after 3D BIM views

The situation

On the project, MEP modelling was split between specialist teams, with sprinkler systems developed separately. Our part was the mechanical services model.

At the start of coordination, the first 300 mm below the structural slab was allocated exclusively to sprinkler pipework. Our mechanical services were therefore coordinated around that agreed zone.

The disciplines didn’t all progress at the same pace. As the sprinkler design developed, parts of the pipework moved beyond the original 300 mm zone and into areas already occupied by coordinated mechanical services.

The change

The sprinkler routing moved below the agreed 300 mm zone.

On paper, a relatively small change. In the model, it meant that sprinkler pipework was now passing through already coordinated mechanical routes.

And none of the services could simply be moved:

  • Lower a duct and it conflicts with the suspended ceiling
  • Move pipework horizontally and structural beams or other MEP services can block the route
  • Move one service and the available space for another disappears

Every adjustment could create a new clash somewhere else in an already coordinated ceiling void.

Before: plan view showing sprinkler pipework running beyond the agreed 300 mm coordination zone, 40 Leadenhall Level 07
Before (plan): sprinkler pipework extending beyond the agreed coordination zone

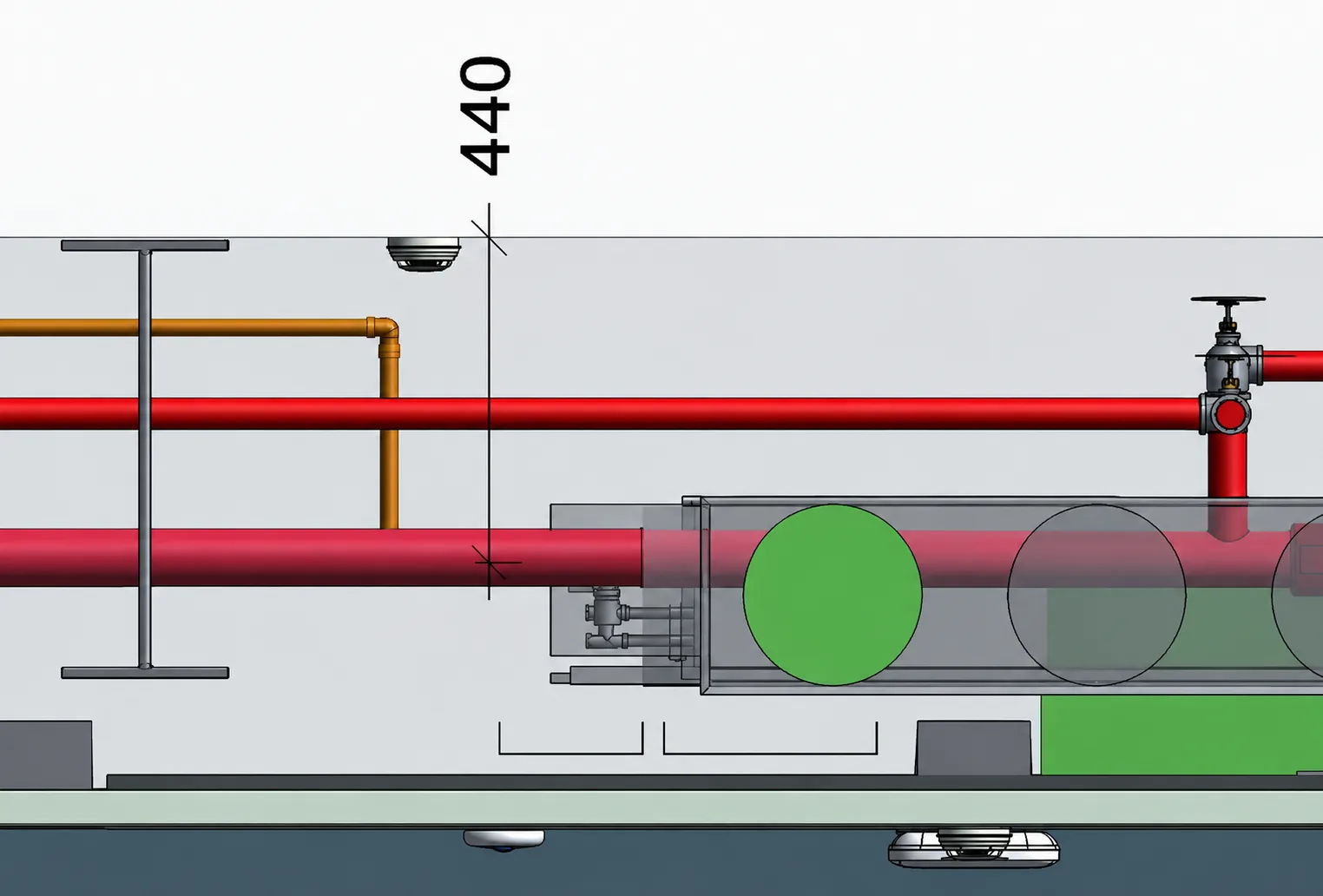

Before: section showing sprinkler pipework dropped below the agreed 300 mm zone into the mechanical services, 40 Leadenhall Level 07
Before (section): sprinkler pipework below the agreed 300 mm zone

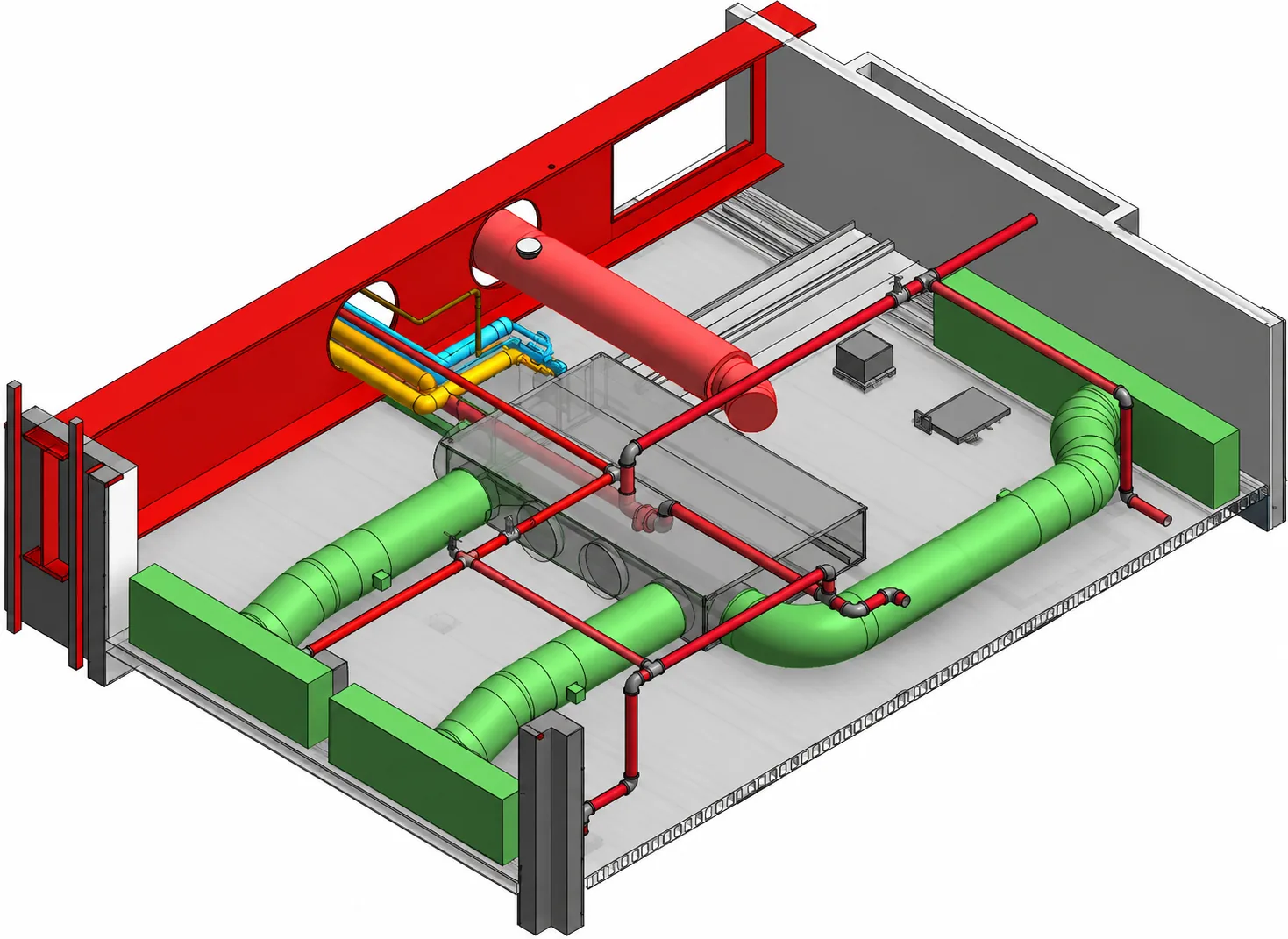

Before: 3D view of sprinkler pipework clashing with coordinated mechanical ductwork, 40 Leadenhall Level 07
Before (3D): sprinkler pipework passing through coordinated mechanical routes

What we did

We could have treated each clash as an individual issue and moved the mechanical services around it. We did neither. We reviewed the affected areas as a whole, looking at the sprinkler routing together with the mechanical services, structure and ceiling constraints. Different routing options were assessed to find the most practical solution, rather than simply resolving each clash independently.

The mechanical services were then re-coordinated around the progressed sprinkler design, with each adjustment checked against the surrounding systems for coordination and buildability.

After: plan view with mechanical services re-coordinated around the revised sprinkler routing, 40 Leadenhall Level 07
After (plan): mechanical services re-coordinated around the sprinkler routing

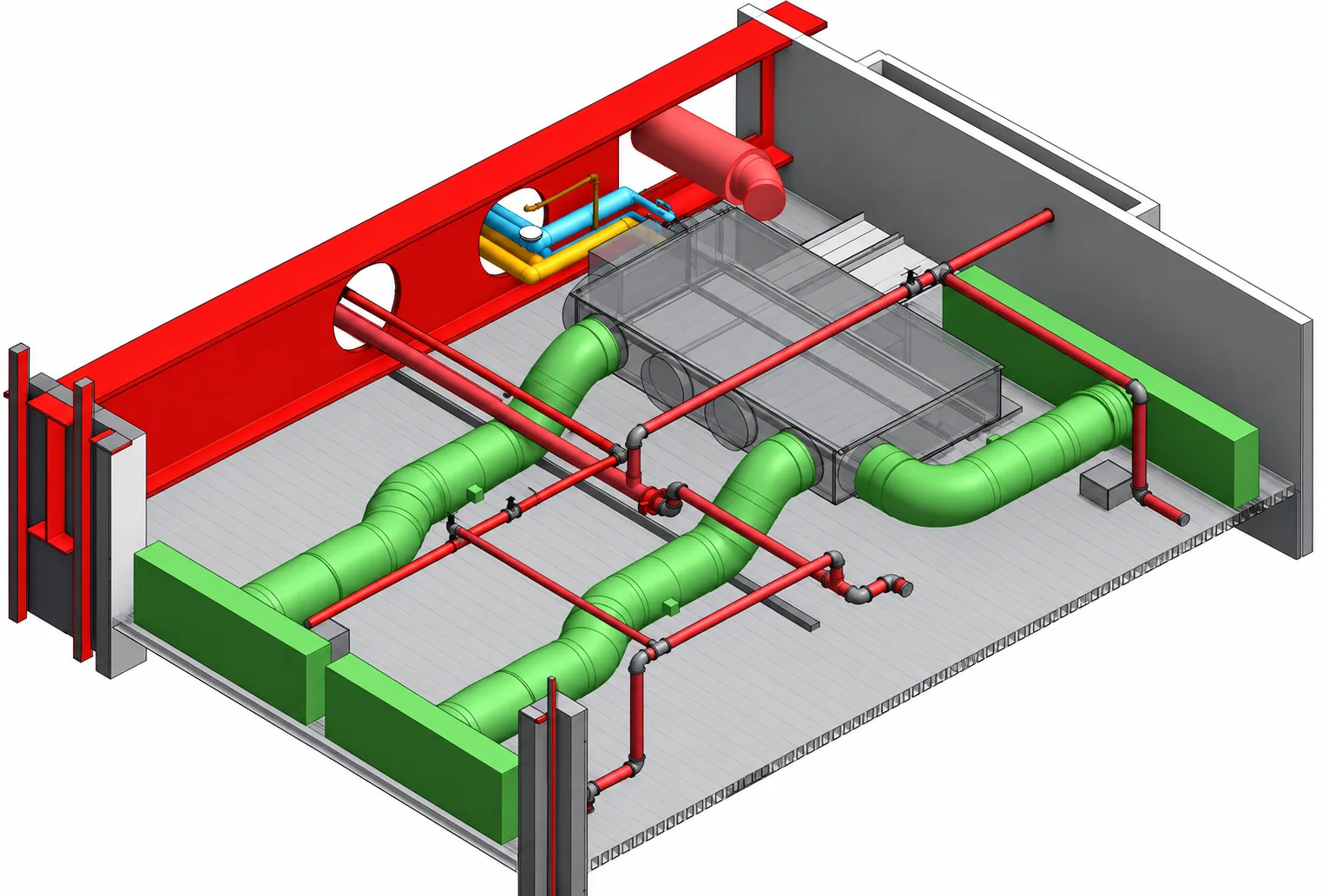

After: 3D view with mechanical ductwork re-coordinated around the revised sprinkler routing, 40 Leadenhall Level 07
After (3D): the same area, mechanical services re-coordinated around the sprinkler routing

The result

The affected areas were brought back into coordination with the progressed sprinkler design, while maintaining the required ceiling constraints and practical installation routes.

The mechanical and sprinkler services were coordinated together without creating new issues for the surrounding disciplines.

What this means for you

The real test of a BIM partner isn’t the first coordination pass. It’s what happens when one discipline changes after the others have already been coordinated.

A well-coordinated model isn’t one where every service stays exactly where it started. It’s one that can absorb the change.

I had the pleasure of working with Arfin and his team. They helped us with our very limited Revit and BIM knowledge and assisted us during meetings and coordination reviews. They have vast knowledge on the mechanics of the software and were very professional.
Anthony White, BMS — Google review, 5 stars

Project summary

Client
BMS
Project
iSam office fit-out, Level 07, 40 Leadenhall, London EC3
Scope
Mechanical services modelling within a multiple specialist MEP model; sprinkler systems designed and modelled by a separate specialist team
Problem
Sprinkler pipework extended beyond the agreed 300 mm zone, creating clashes with mechanical services that had already been coordinated
Result
Re-coordinated to accommodate the revised sprinkler routing while maintaining access, buildability and compliance
